User's Guide to

RiskyProject

Back to RiskyProject
Project Risk Management and Decision Analysis

Site search powered by Google

Probabilistic and Conditional Branching

Probabilistic and conditional branching can be used in project planning to model projects in which there are two or more possible activities that may succeed an activity, but a decision regarding which activity will be taken has not yet been made.

Probabilistic Branching

Probabilistic branching allows you to calculate expected values (EV) for the project given that you have not yet been able to determine which branch will be executed. This type of branching is useful to calculate the expected value for the project cost given the current uncertainty in the project plan. Probabilistic branching is defined by the probability (chance) that a certain branch will be executed or not executed.

Conditional Branching

Conditional branching is useful when you need to determine expected values of the project under certain conditions. For example, what would be the cost of the project if certain activities will not proceed? What will happen if their predecessors take longer than 100 days to complete? Conditions can be related to:
•  Task duration
•  Task Cost
•  Task Start Time
•  Task Finish Time

Creating probabilistic and conditional branching

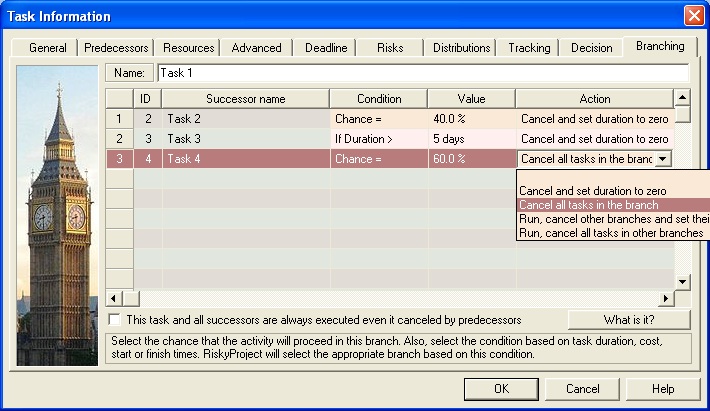

1. Open the Task Information dialog box for the task in which you want to create the branch.
2. Click the Branching tab.
3. For each successor define the Condition and Value that will cause the successor to be cancelled. The type of value you can select is dependent upon the condition you select.
4. Select the Action that will occur when a successor is cancelled or executed.
5. Select the This task and all successors are always executed even if cancelled by predecessors check box if you want to force this task and all successors to be run in the simulation even if its predecessors are canceled.  A task can have multiple predecessors. These predecessors may belong to different branches and can be canceled due to the results of the branching. Select the check box if you want to force this task and all successors to be run in the simulation even if its predecessors are canceled.

6. Click OK.

Example of Conditional and Probabilistic Branching

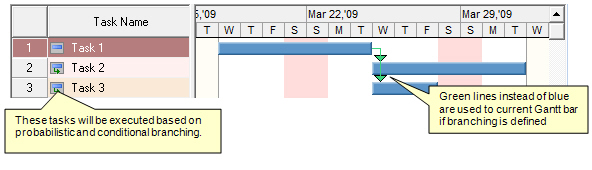

In this case, Task 1 has three successors:
• Task 2 will be canceled in 40% of the time. Task 2’s success rate will be around 60%. This is example of probabilistic branching
• Task3 will be canceled if duration of task1 is greater than 5 days. Task2’s success rate depends on the statistical distribution for duration of Task1. This is example of conditional branching.
• Task4 and all it successors will be canceled in 60% of cases. Task4 success rate will be around 40%. This is example of probabilistic branching.


You may use any risk assignment view or dialog to assign a mitigation and response plan to a risk.

See also
Decision Trees
