RiskyProject Project Risk Management and Risk Analysis Software Suite
Contact Intaver Institute to learn more about this and other features of RiskyProject.
Megaprojects are extremely large-scale, complex ventures—typically costing over $1 billion—involving multi-year timelines, thousands of activities, and dozens of contractor interfaces. When project risk managers attempt to run Monte Carlo simulations across these massive integrated structures, traditional risk software struggles under the weight of the data.
Challenges with Analysis of Large Integrated Project Schedules
Analyzing large integrated project schedules presents unique computational and structural hurdles. Detailed execution schedules often contain tens of thousands of tasks, complex logic ties, and external constraints. Processing these massive models in conventional Monte Carlo tools often leads to severe performance degradation, causing simulations to slow down and an analytics such as sensitivity analysis, can be compromised due to the enormous amounts of data (white noise).
At the same time, attempting to manage these challenges manually creates significant risks:
- Manual Reduction Errors: Manually creating summary schedules to speed up calculations often severs critical logic paths, introduces human error, and skews the statistical results.
- Detail Noise: Excessively granular tasks can introduce statistical noise that obscures the primary risk drivers that truly threaten project completion.
- Data Disconnects: Uncoordinated subprojects managed in silos make it difficult to maintain a consistent, portfolio-wide view of schedule and cost risk.
Effective analysis requires tools capable of processing large-scale schedule logic quickly and accurately, eliminating performance bottlenecks without sacrificing the underlying mathematical and logical rigor of the model.
How RiskyProject Tames Megaprojects
RiskyProject provides specialized capabilities designed specifically to handle large integrated schedules and programs efficiently.
-
Algorithmic Schedule Consolidation

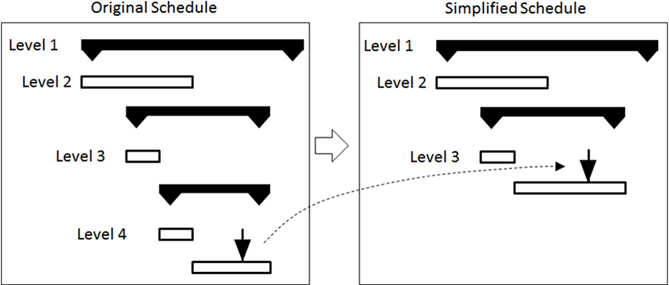

Rather than manually deleting or summarizing activities, RiskyProject uses computer algorithms to condense sequential and repetitive tasks.
- Equivalent Project Schedule: The algorithm generates a mathematically equivalent schedule model that preserves vital driving logic, dependencies, and critical paths.
- Error Reduction: Automating the consolidation process eliminates the human errors and logic breaks inherent in manual schedule simplification.
- Reduced Task Count: Task counts are reduced significantly, leading to faster simulation runtimes without compromising logic.
-
Subproject Simulation and IPS Integration
To manage complex master schedules efficiently, RiskyProject enables subprojects to be calculated independently before being integrated into the master plan:
- Separate Subproject Calculation: Run full Monte Carlo simulations on individual subproject files to capture localized risks, activity uncertainties, and correlations.
- Statistical Risk Profiles: Convert subproject results into comprehensive statistical distributions representing duration, cost, start, and finish parameters.
- Integrated Schedule Insertion: Insert these subprojects directly into the main Integrated Project Schedule as single summary tasks that embed the underlying statistical risk profiles, giving the master schedule full statistical visibility without overwhelming the risk engine.
-
High-Performance Calculation Engine
RiskyProject is engineered specifically to process massive schedule networks at high speed:
- Multi-Core Processor Support: The simulation engine fully utilizes modern multi-core processors, distributing Monte Carlo iterations across available processing power to drastically reduce execution time.
- Optimized Critical Path Algorithm: The critical path calculation engine is optimized specifically for Monte Carlo simulations, enabling rapid recalculation of network paths across thousands of simulation iterations on large-scale models.
-
Integrated Quality Control and Centralized Risk Registers
A Monte Carlo simulation is only as reliable as the underlying schedule logic. RiskyProject integrates quality control directly into the workflow:
- Monte Carlo-Tailored Schedule Inspection: Built-in schedule diagnostics inspect the network specifically for issues that invalidate risk simulations, such as missing logic, artificial constraints, and severe lags. It includes standard diagnostics like the DCMA 14-Point Assessment to verify schedule health prior to running calculations.
- Centralized Risk Register: Manage qualitative and quantitative threat and opportunity registers in a unified database, linking risk events directly to tasks and schedule networks.
Strategic Workflow for Large Integrated Schedules
- Schedule Diagnostics & Health Inspection: Audit all subprojects and integrated master schedules using built-in inspection tools and DCMA 14-point checks to ensure logic integrity before simulating.
- Subproject Simulation: Calculate Monte Carlo simulations on individual subprojects to generate precise statistical risk distributions.
- Master Schedule Integration: Embed subproject risk distributions into the overarching Integrated Project Schedule.
- High-Performance Execution: Run portfolio-wide Monte Carlo simulations using multi-core processing to evaluate total cost and schedule risk across the entire program.
